How long does screed take to dry? Most screeds can be walked on within 24 to 48 hours, but being dry enough for tiles, wood or vinyl takes far longer. As a rule of thumb, screed dries at about 1mm a day for the first 40mm and half that speed beyond it, in good conditions of 20°C and 65% relative humidity. That puts a typical 50mm anhydrite liquid screed at around two months, a cementitious liquid screed at around two to four weeks, and a 75mm sand and cement screed at well over three months.
Those numbers move a lot depending on the product, the depth and, above all, the conditions on site. This guide breaks drying times down by screed type, explains what speeds drying up or slows it down, and covers the part most people skip: proving the floor is dry before anything goes on top.
Screed Drying Times at a Glance
Here’s how the main screed types used in UK homes and extensions compare under good drying conditions.
Screed type
Walk on
Typical time until ready for floor coverings*
Force drying
Calcium sulphate (anhydrite) liquid screed, 40 to 50mm
24 to 48 hours
Around 40 days at 40mm, around 60 days at 50mm
Yes, from 7 days
Cementitious liquid screed (e.g. Cemfloor), up to 50mm
24 hours
Around 15 days at 20°C, 21 days for conventional tile adhesive, 28 days for wood or laminate
5 days for non moisture sensitive coverings, 7 days to 75% RH
Not normally needed
Traditional sand and cement, 65 to 75mm
24 to 48 hours
Roughly 90 to 110 days using the BS 8204 rule of thumb
Only once the screed is strong enough
*Based on manufacturer figures at around 20°C and 65% relative humidity. Always confirm with a moisture test before laying floor coverings.
The 1mm a Day Rule, and Where It Breaks Down
The figure you’ll hear from most screeders comes from the British Standard for screeds. Gyvlon’s post installation guidance describes it as a rough guide from BS 8204: standard traditional and flowing screeds dry at roughly 1mm a day up to 40mm, then about half a millimetre a day after that, in very good conditions of 20°C and 65% RH.
Run the numbers and the depth penalty becomes obvious:
40mm screed: about 40 days
50mm screed: about 60 days
65mm screed: about 90 days
75mm screed: about 110 days
The catch is that word “very good”. An unheated extension in a damp British autumn is nowhere near 20°C and 65% RH. Gyvlon notes that cold, humid sites above 70% RH greatly increase the number of days a screed takes to dry, and low indoor temperatures slow it further. So treat the rule as a best case for planning, not a date to book your flooring fitter.
How Long Does Screed Take to Dry by Type?
Calcium Sulphate (Anhydrite) Liquid Screed

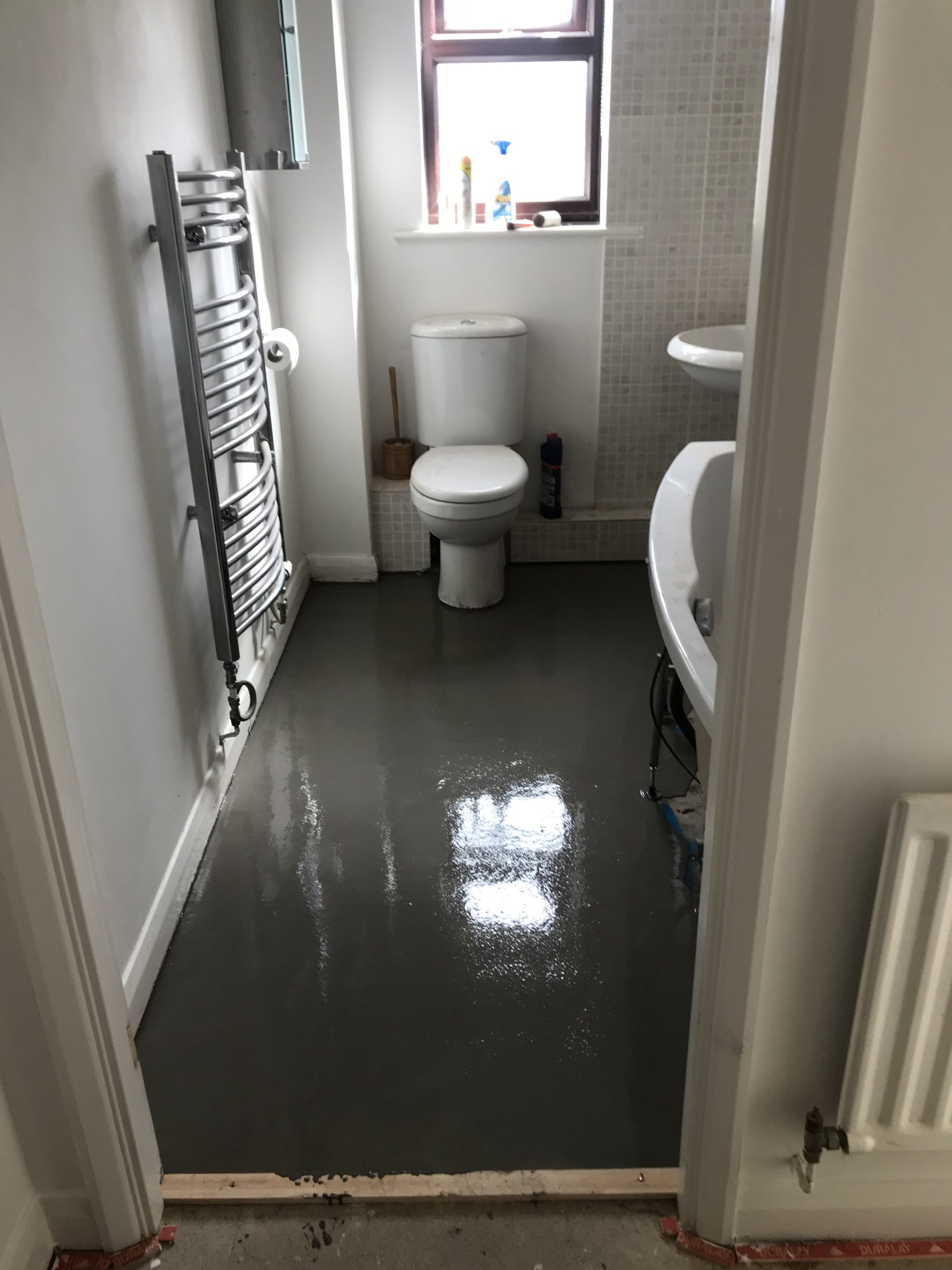

Anhydrite screeds such as Gyvlon and Gypsol follow the 1mm a day rule closely. Our own liquid screed aftercare guide puts a typical 40mm screed at around 40 days to reach 0.5% moisture content in ideal conditions. Light foot traffic is usually fine after 24 to 48 hours, and the Flowing Screeds Association confirms that range as standard for flowing screeds.
The big advantage of anhydrite is that it can be force dried. Dehumidifiers can go in from around 72 hours, and underfloor heating can be commissioned from 7 days. Most standard anhydrite screeds also need sanding 3 to 10 days after installation to remove surface laitance, which opens the surface up and helps it dry. If you’d rather not do that yourself, our laitance removal service handles it.
Cementitious Liquid Screed
Cement based liquid screeds tend to dry faster than anhydrite. The Cemfloor technical data sheet gives typical drying times of 15 days for thicknesses up to 50mm at 20°C and 65% RH or less. For specific floor finishes it suggests 21 days before tiling with a conventional adhesive and 28 days for solid wood or laminate, falling to 11 to 13 days when underfloor heating is used to force dry it.
Cementitious screeds also don’t leave a weak surface laitance once cured and can go into permanently wet areas, which is why they’re often chosen for bathrooms and wet rooms.
Rapid Drying Screeds
When the programme is tight, rapid drying mixes change the picture completely. Marshalls’ Longfloor IntegraCure Rap7D data sheet states the screed reaches 75% RH seven days after installation at 50mm thick, with non moisture sensitive coverings possible from five days. On the anhydrite side, Gyvlon’s Advanced range with its E2C additive is described as drying twice as fast as standard screeds. Both still depend on decent site conditions, but they can take weeks off a build.
Traditional Sand and Cement Screed
Sand and cement is the slowest of the lot, mostly because it’s laid thicker. The FSA notes a typical traditional screed over insulation is around 75mm, compared with 40mm for a flowing screed. At 75mm, the rule of thumb points to more than three and a half months of drying. Cement based screeds can also be sensitive to losing moisture too early, so heaters and dehumidifiers shouldn’t go in until the screed has gained enough strength.
What Slows Screed Drying Down
Thickness is the obvious one, but site conditions usually make the bigger difference.
Cold air. Water evaporates far more slowly in a cold building, so winter pours almost always take longer.
High humidity. If the air is already damp, it can’t take much more moisture from the screed and drying stalls.
Poor airflow. Still air sits just above the surface and holds moisture there.
Covering the floor. Gyvlon warns that stacking plasterboard and materials on a screed for long periods delays drying underneath.
Extra water. Hosing the floor down, leaks and late wet trades all put moisture back in.
Gas heaters. Fossil fuel heaters release water vapour and raise humidity, so Gyvlon advises against them.
How to Speed Up Screed Drying Safely
Ventilation does most of the work. Once the first 48 hours of curing are over, open windows and doors during the day so moist air can escape, then close them at night. Both the Gyvlon and Cemfloor guidance recommend this daily routine, with Cemfloor’s starting from 72 hours.
Where windows can’t be opened, dehumidifiers help, as long as the doors are kept shut so they’re not trying to dry the whole street. Avoid blasting the surface with direct hot air. Cemfloor’s data sheet warns that direct heating by hot air or radiant heat can cause curling.

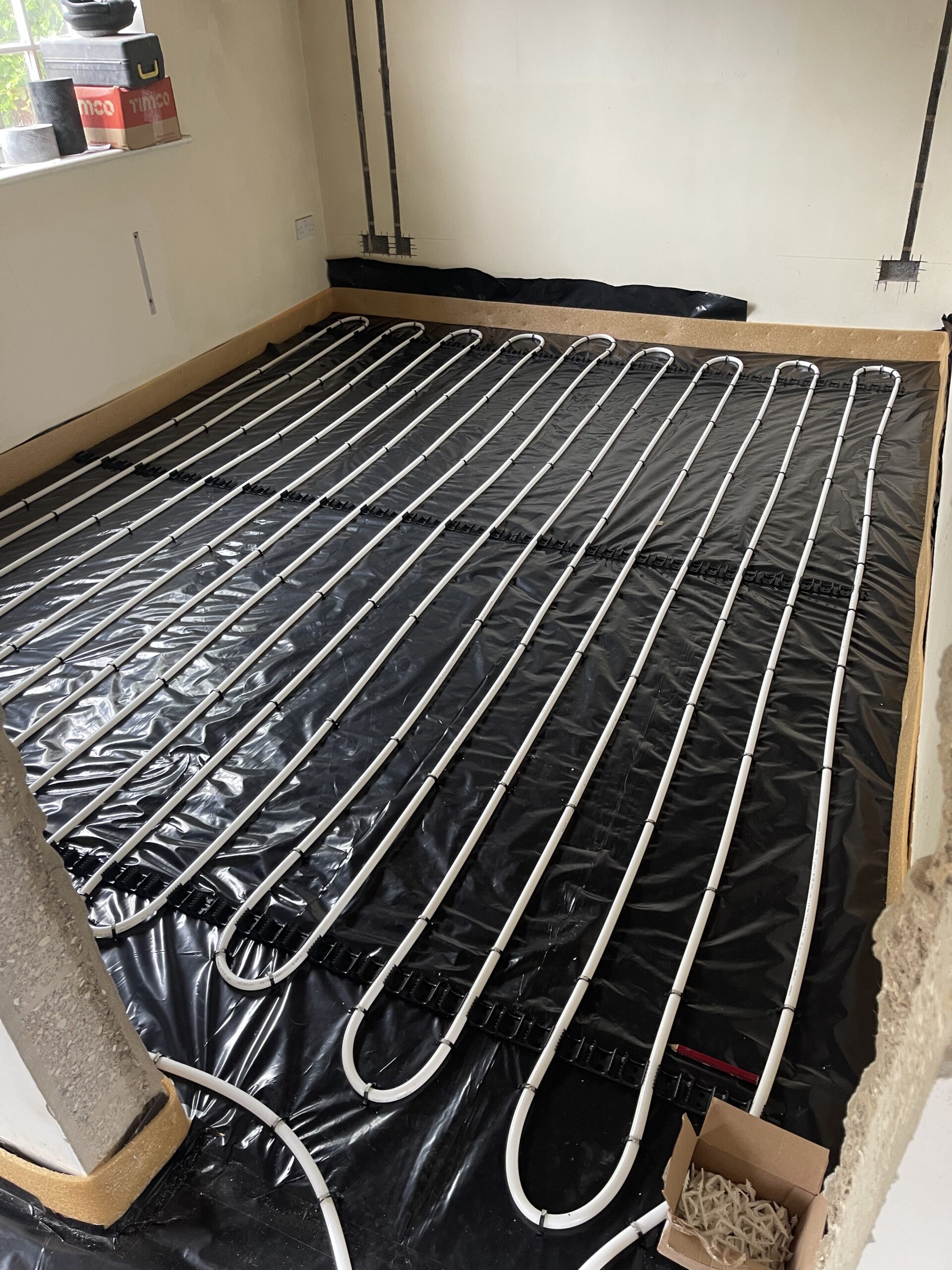

Using Underfloor Heating to Dry Screed
If you’ve got wet underfloor heating in the floor, it’s your best drying tool. The FSA says it can usually be switched on after 7 days, starting at a low temperature and raising it gradually under the screed and heating manufacturers’ guidelines, with the process signed off by a qualified person.
Gyvlon’s commissioning sequence is a good example of what that looks like. Start at around 20°C for 24 hours, raise the manifold temperature by 5°C a day up to the maximum commissioning temperature (up to 45°C), hold it there for 5 days, then bring it back down by 5°C a day. The system is then switched off and left to cool for 48 hours before moisture testing. Cemfloor’s process is similar but allows up to 55°C, held for 4 days.
Commissioning isn’t optional, either. Cemfloor’s data sheet is clear that no floor finish should go onto a heated screed until the system has been fully commissioned and run.
How to Tell When Screed Is Actually Dry
You can’t tell by looking at it. A screed can look pale and feel hard while still holding enough moisture to ruin a wood floor. The only reliable answer is a moisture test, and the FSA says the usual maximum is 75% relative humidity using the British Standard method, though the floor covering manufacturer’s limit always takes priority.
Anhydrite screeds need a little more care. Gyvlon points out that surface hygrometers aren’t accurate on calcium sulphate screeds at higher moisture levels, and recommends a carbide (CM) test or oven drying instead. As a rough conversion, 75% RH is about 0.5% moisture content. Limits also vary by finish. Gyvlon’s standard range allows up to 1.0% for loose laid carpet, 0.5% for bonded vinyl and just 0.4% for bonded engineered wood.
Common Drying Mistakes to Avoid
Booking the flooring fitter based on the calendar rather than a test result.
Laying wood or vinyl over a heated screed before the underfloor heating has been commissioned.
Using a standard cement based tile adhesive on an anhydrite screed that hasn’t reached its moisture target.
Leaving the laitance on an anhydrite screed, which is too weak to bond to and slows drying.
Testing straight after running the heating, when the floor hasn’t cooled for 48 hours.
Plan Your Floor Around the Drying Time
The best way to avoid delays is to choose the right screed at the start. If your programme is tight, a cementitious or rapid drying mix may save weeks. If you’re fitting underfloor heating, an anhydrite screed can be force dried with the system itself. Either way, building realistic drying time into the schedule is cheaper than lifting a failed floor.
Express Liquid Screeds installs both calcium sulphate and cementitious liquid screeds as approved installers for the major UK manufacturers. If you’re new to the options, our guide to what liquid screed is is a good place to start. Get in touch and we’ll recommend the mix and drying plan that fits your project.
FAQs
How long after screeding can you walk on it?
Most liquid screeds take light foot traffic after 24 to 48 hours. Keep heavy traffic and stacked materials off it for at least a week, and protect it with boards if trades need to work on it.
How long does 50mm screed take to dry?
In good conditions, a 50mm anhydrite liquid screed takes around 60 days using the 1mm a day rule. A 50mm cementitious liquid screed such as Cemfloor is typically around 15 days, and a rapid drying mix can reach 75% RH in about 7 days. Cold or humid sites will take longer.
Can you tile onto screed after 7 days?
Only with specific products. Cemfloor allows tiling after around 5 to 7 days with its specialised adhesive, and rapid drying screeds are designed to be ready at 7 days. A standard anhydrite screed won’t be dry enough, so wait for a moisture test result.
When can I turn on underfloor heating after screeding?
Usually after 7 days, starting at a low temperature and raising it gradually by around 5°C a day. The commissioning process should follow the screed and heating manufacturers’ guidance and be signed off before any floor covering is laid.
Does screed dry faster in summer?
Generally yes. Drying times are quoted for around 20°C and 65% relative humidity, so warm, dry, well ventilated conditions help a lot. In winter, heating, dehumidifiers or commissioning the underfloor heating can make up some of the difference.
Concrete laitance is the thin, weak layer of cement fines and water that rises to the surface of concrete or screed as it cures. It forms when mixing water works its way upward through the mix and carries the finest, weakest particles with it, leaving a pale, powdery skin sitting on top of the sound concrete underneath. Left in place, it will not bond properly with adhesives, coatings or floor coverings, which is why removing it is one of the first jobs on any floor preparation schedule.
It catches out a lot of self builders and even some contractors because a freshly finished slab or screed can look perfectly smooth and ready to go. The problem only shows up once tiles start lifting, a resin coating blisters, or a polished topping fails to key in. Understanding why laitance forms makes it much easier to spot early and deal with properly.
What Is Concrete Laitance?
Laitance is a layer of hydrated cement and fine aggregate particles, usually pale grey or white, sitting on the surface of a poured floor. It is soft and friable, meaning it can be scraped away with a fingernail or the edge of a screwdriver, and it ranges from a fine dust you can barely see to a crust several millimetres thick depending on how the concrete was mixed, placed and finished.
The same thing happens on flowing screeds, not just traditional poured concrete. Anyone installing a liquid screed or a flowing concrete floor deals with the same weak surface layer once the pour has cured, and it has to come off before any bonded floor covering goes down on top.
How Does Laitance Form?
Bleed Water Does the Damage
Laitance starts with bleeding. As the Concrete Society explains, bleeding happens because of the inability of the solid components of the concrete to hold all of the mixing water, so the excess water rises to the top before the cement paste has stiffened enough to trap it in place. Because water is the lightest part of the mix, it carries the finest, least dense particles of cement and sand up with it as it travels.
Once that bleed water reaches the surface and evaporates, or gets worked back into the concrete during finishing, it leaves behind a concentrated layer of weak cement paste with a much higher water to cement ratio than the floor underneath. That weak layer is laitance.
What Makes It Worse
Several things make bleeding, and therefore laitance, more likely or more severe. An overly wet mix is the biggest culprit, since more mixing water simply means more water available to rise. Over trowelling or finishing the surface too early has the same effect. The Concrete Society notes that if the bleed water is remixed during the finishing of the top surface, a weak top surface will result, which is exactly the mechanism behind laitance and the dusting that often goes with it.
Cold, humid conditions can cause condensation on the surface that gets trowelled straight into the mix, and certain cements, particularly those blended with ground granulated blastfurnace slag, extend the bleeding period because they set more slowly. On outdoor pours, rain hitting the surface before it has cured adds even more water into the mix at exactly the wrong moment. Any of these will leave a thicker, more troublesome layer of laitance to deal with once the floor has gone off.
How to Spot Laitance Before It Causes a Problem
Laitance usually shows up as a pale, dusty or matt patch on an otherwise darker floor, often worst at low points where water pooled during the pour. It will powder under foot traffic and mark easily if you sweep or scuff it, and the simplest test is to scratch the surface with a screwdriver or similar tool. If it scrapes away easily down to a harder, more consistent material underneath, that confirms laitance rather than sound concrete.
Why It Has to Come Off Before You Fit a Floor Covering
Any adhesive, primer, resin coating or polished finish needs to bond to strong, consistent material. Laitance sits between the covering and the structural floor as a weak, powdery interface, so floor coverings applied over it commonly delaminate once the floor is in use, because the bond is only ever as strong as the weakest layer. This applies whether the finish going on top is tiling, a resin system, or a polished concrete topping, all of which rely on a sound, mechanically keyed surface to grip onto.
How Laitance Is Removed
The right method depends on the thickness of the layer, the size of the area and what is going down afterwards. On standard screeds and slabs, it is generally worth allowing four to seven days of curing before removal work starts, giving the floor time to gain enough strength that preparation does not damage the surface underneath.
For most residential and commercial floors, diamond grinding or sanding is the standard approach. Fitted with a triple diamond cup disc and run alongside a high powered extraction unit, a low speed sanding machine will cut back the weak surface layer and leave a clean, mechanically keyed finish, usually within a day for most sized rooms. Larger commercial areas are often better suited to shot blasting, which fires steel shot at the surface to strip laitance quickly across bigger floor plates. Thicker or more stubborn deposits sometimes need scabbling with compressed air tools, and acid etching is generally kept as a last resort for thin laitance on floors where mechanical methods are not practical.
Whichever method is used, the dust produced during grinding and sanding contains respirable crystalline silica, and the HSE is clear that exposure needs to be controlled with on tool extraction, damping down where appropriate, and properly fitted P3 rated masks for anyone working nearby. Sealed dust collection rather than letting it settle around the site is worth insisting on if you are bringing in a contractor for this work.
Concrete Laitance vs Efflorescence
The two are often confused because both leave a pale mark on a concrete surface, but they are different problems with different fixes. Laitance is a mechanical layer of weak cement paste left behind by bleed water during curing, and it needs to be ground or blasted off before you can bond anything to the floor. Efflorescence is a white, crystalline deposit of soluble salts, usually calcium carbonate, that forms later as moisture moves through the concrete and evaporates at the surface, leaving the salts behind. It tends to appear well after the floor has cured and is usually dealt with by brushing or a light acid wash rather than full mechanical removal, and it points to a moisture issue rather than a finishing problem.
Preventing Laitance Before It Starts
Prevention comes down to controlling water and timing. Using the correct water to cement ratio, avoiding on site additions of extra water to make a mix easier to place, and holding off on finishing until bleed water has stopped rising and evaporated all reduce the amount of laitance that forms. Proper curing afterwards, whether with a curing compound or a covering of wet hessian or plastic sheet, produces a stronger, more abrasion resistant surface with far less dusting. This is easier to get right when the pour is being managed by an installer who is controlling mix design and finishing on site rather than leaving it to chance, which is exactly why getting the floor preparation stage right from the outset saves time and cost later on.
If you are planning tiling, a resin floor, or a polished topping over a new screed or slab, it is worth having the surface checked for laitance before any finish goes anywhere near it. Removing it properly the first time is far cheaper than lifting a failed floor covering later and starting again.
FAQs
How do I know if my concrete floor has laitance?
Look for pale, dusty or matt patches, especially at low spots where water would have pooled during the pour. Scratch the surface with a screwdriver. If it scrapes away easily to reveal harder, more consistent material underneath, that is laitance rather than sound concrete.
Is laitance the same as efflorescence?
No. Laitance is a weak layer of cement paste left by bleed water during curing and needs mechanical removal. Efflorescence is a crystalline salt deposit that appears later as moisture evaporates from the surface, and it usually needs only brushing or a light acid wash.
How long should concrete or screed cure before removing laitance?
As a general guide, standard screeds and slabs benefit from four to seven days of curing before laitance removal begins, so the floor has gained enough strength to withstand grinding or sanding without further damage. Skin free or low laitance products are handled differently and are often sanded immediately before floor coverings are applied.
Can I remove laitance myself?
Light laitance on a small area can sometimes be dealt with using a hand held grinder, but the dust produced contains respirable crystalline silica, so proper extraction and a P3 rated mask are essential. For larger areas, or where a covering needs a reliably flat, evenly prepared surface, a professional using diamond grinding or shot blasting equipment with dust extraction will give a more consistent result and a safer working environment.
Does laitance matter if I am installing underfloor heating?
Yes. A screed laid over underfloor heating pipework still develops a weak surface layer as it cures, and any floor finish going on top of it needs the same sound, laitance free surface to bond to. Skipping preparation risks the same delamination problems regardless of what is running underneath the floor.
A polished concrete overlay is a thin, hard-wearing layer applied over an existing concrete slab and then ground and polished to a smooth, reflective finish. The main advantages of using polished concrete overlays are that they save you from tearing out a damaged or worn floor, they install and cure far faster than a full replacement, and they produce a durable, low-maintenance surface that can last decades with occasional re-polishing. For anyone weighing up flooring options for a warehouse, showroom, retail unit or home, that combination of speed, strength and finish is hard to match.
This guide looks at where those advantages actually come from, where overlays work best, and what to think through before you commit to one.
What Is a Polished Concrete Overlay?
An overlay is a self-levelling or trowel-applied cementitious topping, often laid from around 10mm thick, bonded to an existing subfloor. Once it’s cured, it’s mechanically ground with progressively finer diamond tooling until the surface is dense, smooth and reflective, in much the same way a natural concrete slab is polished. The difference is that an overlay lets you achieve that finish on a floor that wouldn’t otherwise be suitable, whether that’s because the existing slab is cracked, uneven, contaminated, or simply too thin to grind back on its own.
The Advantages of Using Polished Concrete Overlays
You Don’t Have to Rip Out the Existing Floor
Demolishing and re-pouring a slab is disruptive, expensive and slow. An overlay works with what’s already there. Provided the subfloor has been properly assessed and prepared, and any moisture or contamination issues dealt with first, the existing concrete becomes the base rather than a problem to remove. That’s a large part of why overlays have become a go-to option for renovating tired industrial and commercial floors rather than replacing them outright.
A Much Faster Turnaround
Because there’s no breaking out, no waste disposal and no waiting for a new slab to cure to full strength, overlays move quickly. As an example, Express Liquid Screeds’ polished concrete topping can be applied from just 10mm thick and is polishable within 24 hours of installation, with many projects prepared and completed in under a day. A full replacement, by comparison, typically needs weeks for the new slab to cure before it can take heavy loads or foot traffic.
Genuine Durability, Not Just a Marketing Line
A well-installed polished overlay is dense, hard-wearing and resistant to abrasion, and it doesn’t chip, peel or flake the way a coating or paint system can. It’s also one of the few floor finishes that can be refreshed rather than replaced. When the surface eventually dulls from years of traffic, it can be re-ground and re-polished, which is why manufacturer-backed systems are commonly rated for 25 years or more of service life.
More Design Freedom Than People Expect
Overlays can be tinted, polished to different gloss levels, scored into patterns, or finished with exposed aggregate for a terrazzo-style look, all without the cost of a full terrazzo installation. That makes them as suited to a boutique retail fit-out or a residential kitchen as they are to a distribution warehouse.
A Lighter Environmental Footprint Than Full Replacement
Reusing an existing slab instead of breaking it out and pouring a new one avoids a significant amount of demolition waste and new material. The Concrete Centre has made the case that extending the working life of existing concrete through repair and adaptation, rather than demolition and replacement, is one of the most efficient ways to reduce embodied carbon in a building, since the emissions and resources already invested in that structure are retained rather than wasted. An overlay puts that principle into practice at floor level.
Easier to Keep Clean, With Slip Resistance You Can Actually Measure
A polished surface is dustproof, non-porous and quick to wipe down, which matters in food production, healthcare and retail environments where hygiene standards are strict. Slip resistance is often raised as a concern with any smooth, glossy floor, and it’s a fair question. The UK’s Health and Safety Executive notes that smooth, polished surfaces need proper assessment, since they can become significantly more slippery once wet or contaminated than a textured finish. The Concrete Society recommends a pendulum test value, measured to BS 7976, of 36 or higher to indicate a low slip potential, rising to 41 or higher on ramps and inclines. A properly specified overlay can be finished to meet those figures. Express Liquid Screeds’ own polished topping, for example, is tested to a minimum of 58 dry and 36 wet.
Where Polished Concrete Overlays Make the Most Sense
Overlays are most valuable where the existing slab is structurally sound but cosmetically or functionally past its best. Think worn warehouse floors, former carpet or tiled commercial units, or older industrial buildings being converted into showrooms and offices. They’re also increasingly popular in new-build homes and extensions, applied as a polished finish directly over a liquid screed subfloor, which gives a seamless look without the extra build-up of a separate floor covering.
What to Weigh Up Before You Commit
Overlays aren’t the right call for every floor. The existing slab still needs proper preparation, including moisture testing, crack repair and removal of any residual adhesives or coatings, or the new surface won’t bond correctly. Polished finishes are also harder underfoot and less forgiving than carpet or vinyl, and while the surface itself resists abrasion well, sharp impacts or dragged heavy equipment can mark it. None of these are reasons to avoid an overlay, but they’re worth discussing with your installer before work starts.
How Installation Actually Works
The process starts with an assessment of the existing slab and any necessary preparation work, followed by priming to help the overlay bond. The overlay itself is then poured or trowel-applied, left to cure for the manufacturer’s specified time, and ground back in stages using progressively finer diamond tooling until the required gloss and slip resistance are achieved. Because the whole sequence can be compressed into a single day for smaller areas, it’s realistic to plan an overlay project around a weekend shutdown rather than weeks of downtime.
If you’re weighing up an overlay against a full replacement for your own floor, it’s worth getting a firsthand assessment. A short site visit is usually enough for an installer to tell you whether your existing slab is a good candidate and roughly how quickly the work could be turned around.
FAQs
How long does a polished concrete overlay last?
With proper installation and normal use, a polished overlay typically lasts well beyond a decade, and manufacturer-backed systems are often rated for 25 years or more of service, because the surface can be re-ground and re-polished rather than replaced when it starts to dull.
Is a polished concrete overlay as strong as a full concrete floor?
A correctly specified and installed overlay is dense, hard-wearing and resistant to abrasion, and is suitable for commercial and industrial traffic. Its performance depends heavily on proper subfloor preparation and bonding, which is why an assessment of the existing slab always comes first.
Are polished concrete overlays slippery?
Any smooth, glossy floor needs the right slip resistance for its use, particularly in wet or contaminated areas. Overlays can be finished to specific pendulum test values, in line with HSE and Concrete Society guidance, to suit anything from a domestic kitchen to a food production area.
Can you polish an overlay over an old tiled or carpeted floor?
Yes, once the existing covering, adhesive residue and any contamination have been fully removed and the subfloor has been properly assessed and prepared. This is one of the main reasons overlays are popular for renovating commercial units without a full floor replacement.
How much does a polished concrete overlay cost compared to a new slab?
Costs vary by project, but overlays are generally more cost-effective than demolishing and re-pouring a slab, because they avoid breaking out, waste disposal and extended curing time. Getting a quote based on your specific floor condition and area is the most reliable way to compare the two.
